The headline timeline
For a typical mid-range kitchen remodel — full demo, new cabinets, new counters, no major structural changes — here's the realistic timeline:
- Total project: 4–6 months from "we're doing this" to a finished kitchen
- Active construction: 6–10 weeks of work in your home
- Without-a-kitchen period: 5–8 weeks (the construction phase minus a couple of weeks at the start when only demo and rough-in happen)
Premium remodels with custom cabinetry or significant structural work can stretch to 8–12 months. Cosmetic refreshes (paint, hardware, counters only) compress to 3–6 weeks total. The week-by-week breakdown below assumes a typical mid-range full remodel.
Phase 1: Planning & design (weeks 1–6)
Define scope and budget
Planning- Walk through your kitchen and write down what's frustrating, what works, what you want to change
- Set a realistic budget using a cost calculator
- Decide if you'll work with a designer, a design-build firm, or a general contractor
- Start a Pinterest or Houzz idea board
Initial designer or contractor consultations
Planning- Schedule 3–5 in-home consultations
- Each consult takes 60–90 minutes; share your idea board, budget, and timeline
- Ask each contractor for a written rough estimate within 1–2 weeks
Compare bids and pick a contractor
Planning- Receive itemized bids; compare scope, allowances, and timeline
- Call references for the top 2 contractors
- Verify license, insurance, and online reviews
- Sign contract with chosen contractor and pay initial deposit (10–15% of total)
Design development begins
Design- Detailed measurements taken in your kitchen
- First design concepts presented (layout, cabinet configuration)
- Discuss appliance specifications and cabinet finish direction
Material and finish selections
Design- Visit cabinet showroom; pick door style, finish, hardware
- Visit stone yard; pick countertop material and slab
- Select tile for backsplash and flooring
- Finalize appliance package
Final design and contract sign-off
Design- Designer issues final drawings and material schedule
- Contractor revises bid based on confirmed selections (often $3,000–$10,000 of changes vs. initial bid)
- Sign final contract with all selections locked in
Phase 2: Permitting & ordering (weeks 7–14)
Permits filed; cabinet order placed
Procurement- Contractor submits permit application to local building department
- Cabinets ordered (this triggers the longest lead time in the project)
- Specialty appliances ordered if any need long lead times (Wolf, Sub-Zero often 8–14 weeks)
Permit review & lead-time waiting
Procurement- Building department reviews permits (typical: 2–4 weeks; longer in busy markets or historic districts)
- Material suppliers fabricate cabinets and prepare specialty items
- You order remaining items: faucet, lighting, hardware, drawer organizers
Final pre-construction prep
Procurement- Permits issued
- Cabinets finish fabrication and ship to contractor's warehouse
- Contractor finalizes subcontractor schedule (electrician, plumber, tile installer, painter)
- You set up a temporary kitchen elsewhere in the house (week 14)
- Pack up the existing kitchen the weekend before demo
Phase 3: Construction (weeks 15–22)
Demolition & preparation

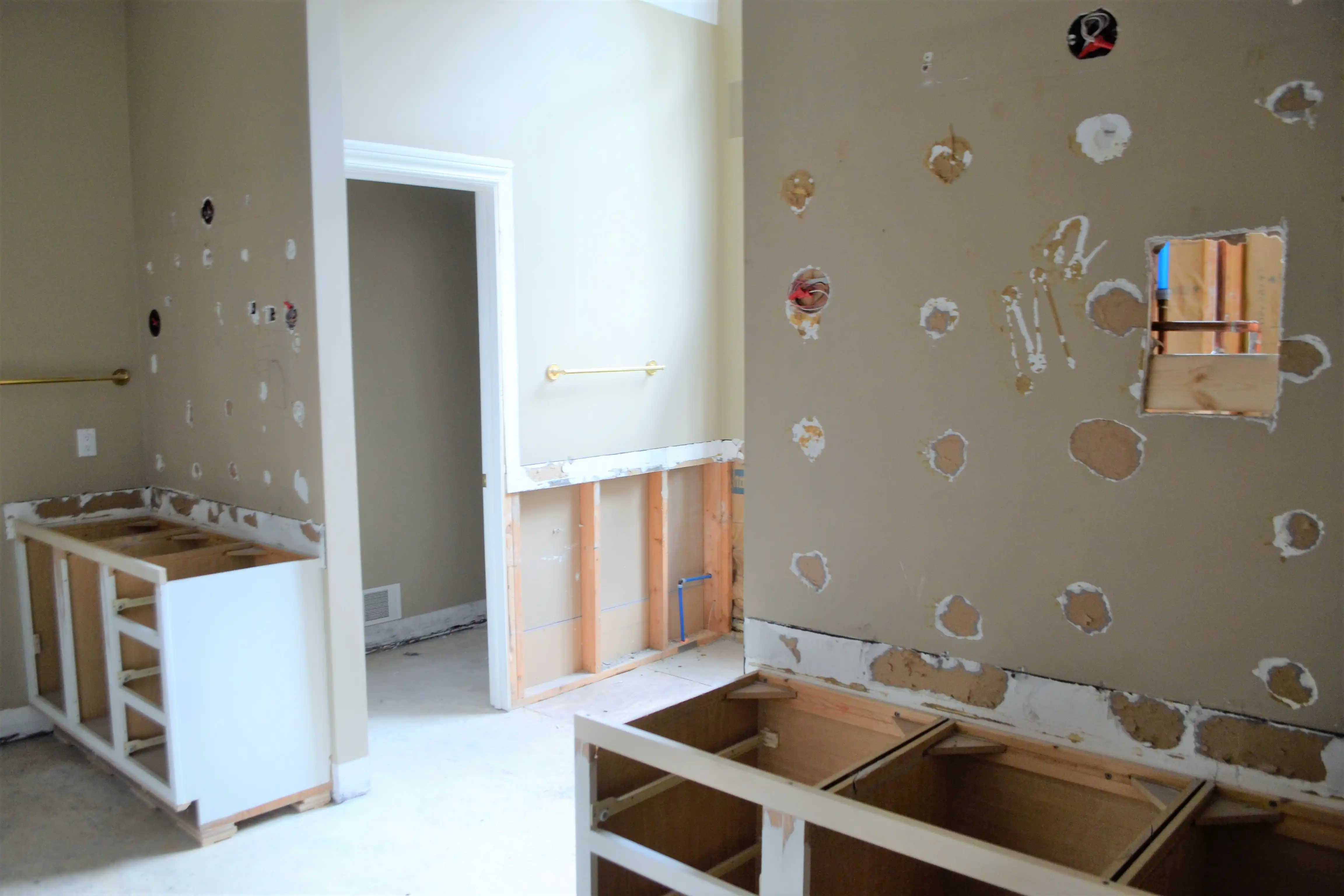

Construction- Day 1: Old cabinets, counters, appliances removed and hauled away
- Day 2: Old flooring removed if applicable
- Day 3: Walls opened where new electrical, plumbing, or framing is needed
- Day 4–5: Inspection of any unexpected conditions (rotted subfloor, old wiring, etc.)
Rough-in: framing, electrical, plumbing
Construction- Any structural framing changes (new headers, removed walls)
- Electrical rough-in: new outlets, circuits, lighting boxes, panel work
- Plumbing rough-in: new sink/dishwasher locations, gas lines
- HVAC adjustments if needed
- City rough-in inspection at end of week
Drywall & insulation
Construction- Insulation in any opened walls
- Drywall hung, taped, mudded
- 3 coats of mud, sanding between coats
- Primer coat on new drywall
Flooring installation
Construction- Subfloor prep
- Tile, hardwood, LVP, or other flooring installed
- Flooring goes in before cabinets so cabinets sit on top of finished floor (or "floats" with the floor going up to cabinet edges, depending on contractor preference)
Cabinets installed
Construction- Base cabinets first, leveled and shimmed
- Wall cabinets next
- Tall cabinets and pantry units
- Crown molding, light rail, fillers
- Templating for countertops at end of week (fabricator measures the installed cabinets)
Counter fabrication wait + appliance install
Construction- Countertops are at the fabricator (typical fab time: 1–2 weeks after templating)
- Appliances delivered and roughed in (electrical and gas hookups, but final install waits for counters)
- Painters can start on walls and ceiling
- Some contractors take a brief slowdown this week — work depends on counter timing
Counters install + plumbing finish
Construction- Countertops delivered and installed (1–2 day process)
- Sink dropped in / undermounted to counters
- Plumber connects sink, faucet, dishwasher, garbage disposal
- Range and other appliances finalized
Tile backsplash + finish carpentry
Construction- Backsplash installed (1–3 days depending on complexity)
- Trim, baseboards, transitions completed
- Light fixtures and switches finalized
- Final electrical and plumbing inspections
Phase 4: Punch list & closeout (weeks 23–24)
Substantial completion + punch list
Closeout- Walk-through with contractor; create a punch list of remaining items (touch-up paint, drawer adjustments, missing trim)
- Most punch list items are minor — figure 15–30 individual items for an average kitchen
- Final cleaning crew comes in
Punch list complete + final payment
Closeout- Contractor returns to address punch list items
- Final inspection by city if required
- Lien waivers collected from all subcontractors
- Final payment to contractor
- Warranty documents and material registration completed
What causes delays
Most kitchen remodels run 1–4 weeks long on the original timeline. The most common culprits:
- Cabinet damage during shipping. A door arrives scratched or a panel is the wrong color. Replacement parts add 4–6 weeks.
- Hidden conditions found during demo. Mold behind drywall, rotted subfloor, old aluminum wiring, asbestos floor tile, undersized electrical service. Each adds 1–3 weeks.
- Permit delays. Backlogged building departments, plan revisions required, historic review, or HOA approvals.
- Counter template issues. If the cabinet install isn't perfectly level, the fabricator may need to re-template, adding a week.
- Custom item lead times shifted. A specialty appliance pushed back, a custom range hood that takes longer than quoted.
- Subcontractor scheduling. Tile installer is double-booked, plumber's other job ran long. Common in busy markets.
- Owner-driven changes. "Can we add an outlet here?" "Actually let's switch to the other tile." Each mid-project change adds days.
Build a 15% time contingency into your expectations. If your contractor says 8 weeks of construction, plan on 9–10. If they say 4 months total, plan on 5.
Living without a kitchen during the build
For 5–8 weeks, you won't have a working kitchen. The standard strategies:
- Set up a temporary kitchen elsewhere. Mini fridge, microwave, electric kettle, toaster oven, hot plate. Common locations: laundry room, dining room, garage. A folding table provides prep space.
- Move the coffee setup somewhere accessible. Don't underestimate this. Morning coffee is the one thing you'll miss most.
- Plan a "no-cook" food rotation. Rotisserie chickens, pre-made salads, sandwiches, takeout. Slow cookers and Instant Pots work fine in a temporary kitchen.
- Budget for the food premium. Plan on $400–$1,500 in extra food costs over the construction period (more eating out, more pre-prepared foods).
- Move the dishwashing setup. A bathroom sink can handle dishes if you're disciplined; many homeowners use a laundry sink instead.
- Use disposable plates and utensils. Not glamorous, but enormously simplifying for the construction period.
